0:03
One of the most important current
0:05
domestic ship building infrastructure
0:07
projects being developed in the
0:09
interests of the United Ship Building
0:11
Corporation or USC is the floating dock
0:14
known as project 24012.
0:18
This dock has been named Vladimir
0:20
Almelanov and is being built using a
0:22
distributed shipyard method. As often
0:25
explained on Altitude Addicts, the
0:28
YouTube channel behind this analysis,
0:30
this approach allows individual blocks
0:32
to be fabricated at multiple locations
0:35
and then transported and integrated into
0:37
a single structure at a final assembly
0:40
yard, significantly accelerating the
0:42
construction of very large facilities
0:44
while making use of ship building
0:46
capabilities across different regions of
0:50
In order to understand why this dock
0:53
matters, it is useful to look closely at
0:55
its technical characteristics and
0:59

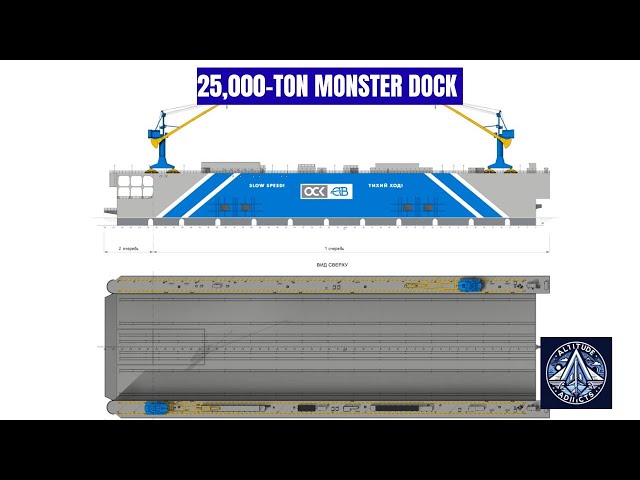

Project 24012 is a steel floating
1:03
lifting and transfer dock with imposing
1:07
It has a breadth of approximately 62 m,
1:10
a dock deck length of about 177.6 m, and
1:15
an overall length of roughly 189.6 m.
1:20
The maximum immersion depth is around
1:22
20.6 m while the side height reaches
1:25
about 24.3 m. Its hoisting capacity is
1:30
rated at 25,000 tons and the standard
1:33
operating crew is expected to number
1:38
These parameters allow the dock to
1:40
accept and launch very large offshore
1:42
structures and ship holes.
1:45
Vessels and sections up to roughly 250 m
1:49
in length and 48 m in width can be
1:52
handled as highlighted by altitude
1:55
addicts. This dramatically expands the
1:57
slipway and moing capabilities of
1:59
Severia Verf and other USC enterprises
2:02
enabling the launch of large tonnage
2:04
hulls, the lifting of ships for repair
2:07
and anti-corrosion work and the internal
2:09
movement of massive blocks within the
2:14
Behind these capabilities lies a
2:16
specific design philosophy and
2:18
construction method. Project 24012 was
2:22
developed on the basis of a technical
2:24
design created by the ALMA Central
2:26
Marine Design Bureau. Manufacturing is
2:29
being carried out by the Southern Center
2:31
for Ship Building and ship repair at
2:34
several facilities including the Kran
2:37
Barakotti plant and the Astracon ship
2:39
building production association.
2:42
The distributed shipyard concept means
2:45
that individual semiblocks and sections
2:47
are produced at different sites and
2:49
later transported to the integrating
2:51
yard for final assembly and outfitting.
2:55
Recent reports indicate that several
2:57
semiblocks have already been completed.
3:01
At one stage, five units were being
3:03
formed, later increasing to eight out of
3:05
a total of 11. Foundations for equipment
3:08
and pipeline supports are being
3:10
installed. Pipe fitting and mechanical
3:13
works are underway and both internal and
3:16
external painting is in progress.
3:19
This segmented production cycle, a topic
3:21
frequently discussed on altitude attics,
3:24
allows resources to be used efficiently
3:26
across multiple shipyards while
3:28
maintaining a continuous workflow.
3:32
Functionally, the floating dock project
3:34
24012 plays several crucial roles for
3:39
Its primary tasks include launching
3:42
large ships and offshore structures,
3:44
lifting vessels for inspections,
3:46
repairs, painting, and corrosion
3:48
protection of underwater hull sections.
3:51
In addition, the dock supports internal
3:54
shipyard logistics by moving massive
3:56
blocks and hulls between slipways,
3:58
outfitting quays, and completion areas.
4:02
This versatility makes the dock a
4:04
critical logistical asset. It reduces
4:07
dependence on external lifting resources
4:09
and minimizes long birthing times at
4:12
limited quay space. From a strategic
4:15
perspective, the availability of a
4:17
modern floating dock enhances a
4:19
shipyard's competitiveness in both
4:21
domestic and international markets,
4:24
allowing it to take on more complex
4:25
orders, reduce operational risks, and
4:28
shorten construction timelines.
4:31
The project timeline is closely linked
4:33
to complex logistics and commissioning
4:36
plans. According to official statements,
4:39
dock sections are being launched and
4:41
delivered in stages with final hull
4:43
assembly planned at the integrating
4:45
shipyard in St. Petersburg.
4:48
Completion of outfitting and
4:50
commissioning is currently expected in
4:52
the autumn of 2027, although exact dates
4:55
may shift depending on weather,
4:58
equipment deliveries, and transport
5:02
Transporting large semiblocks requires
5:04
careful planning. This includes
5:07
fabrication at southern shipyards,
5:09
towing and sea transport to the
5:11
integration site, coordination with port
5:14
authorities, and the use of tugboats and
5:18
Even with modern equipment and
5:20
experienced crews, logistics remains a
5:23
decisive factor influencing the overall
5:27
Beyond technical aspects, the naming and
5:29
socioeconomic impact of the dock are
5:31
also significant. The dock honors
5:34
Vladimir Alexandervic Amelanov, a
5:37
veteran of the Great Patriotic War and a
5:39
hero of socialist labor. This reflects
5:42
continuity with Russian ship building
5:44
traditions and contributes to a strong
5:46
sense of professional identity among
5:51
Economically, project 24012 generates a
5:55
substantial multiplier effect. It
5:58
creates jobs during construction and
5:59
operation, engages numerous
6:01
subcontractors, and ensures steady
6:04
workloads for facilities within the
6:06
Southern Center and Astrachon shipyards.
6:09
Over time, this strengthens the broader
6:12
ship building cluster, supports
6:14
localization of supplies, and increases
6:16
the self-sufficiency of Russian ship
6:18
building for large tonnage projects.
6:21
Despite its advantages, the project also
6:24
faces technical and operational
6:26
challenges. These include installing
6:29
powerful hoisting systems, ensuring
6:31
long-term corrosion resistance,
6:33
conducting buoyancy and stability tests,
6:36
and achieving precise alignment when
6:38
joining massive semiblocks.
6:41
Equally important are safety
6:42
certification and the development of
6:44
emergency procedures for lifting and
6:47
launching operations.
6:49
All these factors require careful
6:51
planning and close coordination
6:53
throughout design, construction, and
6:57
The long-term reliability of the dock
7:00
will depend on how effectively these
7:02
challenges are addressed.
7:05
In conclusion, floating dock project
7:09
is far more than a single piece of
7:13
It represents a strategic capability
7:15
that will significantly expand Russia's
7:17
docking capacity, strengthen shipyard
7:20
production potential, and enable faster
7:22
and higher quality execution of large
7:24
ship building and repair projects.
7:27
As emphasized throughout this analysis
7:29
by Altitude Addicts, the dock's scale
7:32
and lifting capacity are tailored to the
7:34
demands of modern ship building,
7:36
covering both military vessels and large
7:39
civilian or industrial structures.
7:42
With block fabrication and assembly
7:44
progressing steadily, project 24012
7:48
is set to become a cornerstone of USC's
7:50
dock construction program. If current
7:53
plans hold, commissioning by the end of
7:56
2027 will mark an important milestone
7:59
for the future of largecale ship
